Prestons BESS

This document is confidential. Please enter the passcode to continue.本文件为机密文件,请输入密码继续。

Confidential机密文件

Prestons BESSBoard Investment Summary董事会投资摘要

ESR & Rudder  |  Phase 1 (De-risking to FID)

March 2026

Project Size项目规模
200 MW / 800 MWh
Phase 1 Funding第一阶段资金
AUD 10.325 m
FID TargetFID 目标
May 2028

About ESR关于 ESR

What ESR IsESR 简介

ESR is a leading Asia-Pacific real assets manager and developer focused on industrial/logistics and new-economy infrastructure.

ESR 是亚太地区领先的实物资产管理与开发商,专注于工业/物流及新经济基础设施。

Integrated Platform一体化平台

Origination, planning, delivery, asset management, institutional capital solutions.

涵盖项目挖掘、规划、交付、资产管理及机构资本解决方案。

Why ESR为何选择 ESR

Strong capability in site control, development execution, and facilitating long-term capital at FID. ESR holds the 100% lease.

在场地控制、开发执行及 FID 阶段引入长期资本方面具有突出能力。ESR 持有 100% 租约。

Australia Footprint澳洲布局

Established ANZ platform with local delivery capability.

已建立 ANZ 平台,具备本地交付能力。

Working Model合作模式

Partners bring specialist development/energy capability; ESR structures and sponsors transaction pathways.

合作方提供专业开发/能源能力;ESR 负责交易架构与推进。

Project Overview项目概览

Opportunity Overview机会概览

  • Project: 200 MW / 800 MWh BESS
  • Location: Prestons, Sydney
  • Land position: Under exclusivity, secured via option to lease
  • Site size: ~20,000 sqm (BESS + transformers)
  • 项目:200 MW / 800 MWh BESS
  • 位置:Prestons, Sydney
  • 土地状态:已获得排他权,通过租赁期权保障
  • 占地面积:~20,000 sqm(BESS + 变压器)

Key Investment Highlights核心投资亮点

  • Directly adjacent to Liverpool 330 kV / 132 kV BSP substation
  • Favourable MLF and low network tariffs
  • Regular-shaped lot; permissible use for BESS with consent
  • High potential for strong offtakes — pathway to highly contracted / potentially 100% contracted offtake
  • 紧邻 Liverpool 330 kV / 132 kV BSP 变电站
  • 有利的 MLF 及较低网络费用
  • 地块规则,可经审批用于 BESS
  • 强劲的购电协议潜力——有望实现 100% 合同包销

Site Details场地详情

  • Zoning: E5 – Heavy Industrial
  • Status: Serviced and flat
  • Preparation: Removal of existing small buildings + preparation for BESS footings (landowner deliverables)
  • 用途分区:E5 – Heavy Industrial
  • 现状:已通服务、地势平坦
  • 前期准备:拆除现有小型建筑 + BESS 基础准备(业主负责)

Transaction Process交易流程

  1. Exclusivity with owner to finalise option deed and ground lease
  2. Commence option period to conduct due diligence
  3. Complete development and grid connection approval during option period
  4. Exercise option and commence ground lease
  5. Construction
  6. Commence operation
  1. 与业主签订排他权,完成 option deed 及 ground lease
  2. 进入 option period,开展 DD
  3. 在 option period 内完成 DA 及并网审批
  4. 行使 option,启动 ground lease
  5. 施工建设
  6. 开始运营

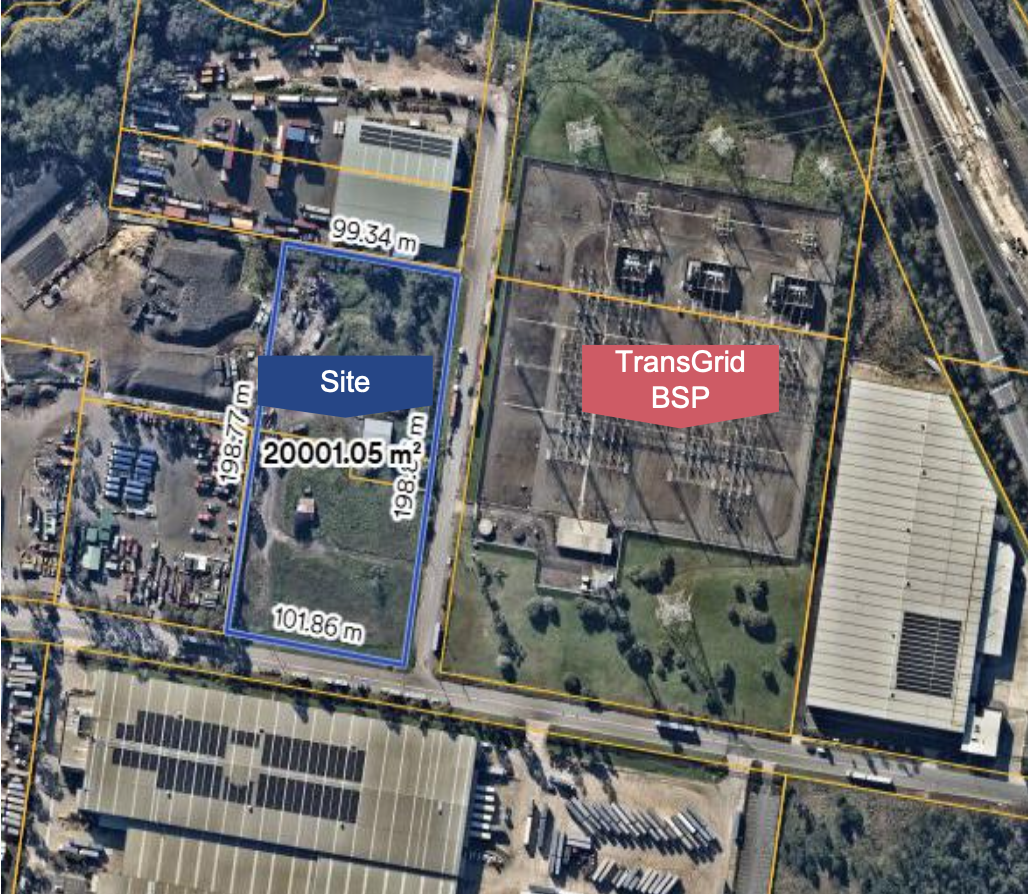

Prestons Site Map
Site adjacent to Transgrid Liverpool BSP

Phase 1 Capital RequirementsPhase 1 资本需求

Total Phase 1Phase 1 总额
AUD 10,325,000
Devex SubtotalDevex 小计
AUD 7,050,000
Land Holding土地持有
AUD 2,875,000
ESR Fees (Devex)ESR 费用 (Devex)
AUD 400,000
ItemCost (AUD)StartDurationEndNotes
DEVEX — Subtotal: $7,050,000
Detailed Due Diligence$350,0001 May 20263 months31 Jul 2026
Upfront Design Costs$200,0001 Aug 20263 months31 Oct 2026
Development Application$3,000,0001 Nov 202618 months30 Apr 2028
Grid Connection Application$2,000,0001 Nov 202618 months30 Apr 2028
Detailed Design & Engineering$500,0001 Nov 202618 months30 Apr 2028
Legals, Financing & Commercials$1,000,0001 Nov 202618 months30 Apr 2028
ESR FEES — Subtotal: $400,000
ESR Dev Fee$400,0001 Aug 202621 months30 Apr 20284% on devex & land holding costs excl. DD
LAND HOLDING — Subtotal: $2,875,000
Option Fee ($30/sqm)$1,200,0001 May 202624 months30 Apr 2028Monthly
Option Period Outgoings ($40/sqm)$1,675,0001 May 202624 months30 Apr 2028Monthly
TOTAL PHASE 1$10,325,000May 202624 monthsApr 2028
What Phase 1 funds:Phase 1 资金用途:
DD Design DA + Grid Approvals Bankable FID Package

Why This Site Is Prime选址优势

Grid Connection Advantage并网优势

  • Direct adjacency to Liverpool BSP — short feeders (reduced capex + lower losses)
  • Ability to connect at 330 kV with capacity to achieve 200+ MW
  • Strong fault level support from dual 330 kV in-feeds (Sydney South / Sydney West)
  • Lower risk of voltage flicker and harmonics vs weaker regional nodes
  • 紧邻 Liverpool BSP——短馈电线(降低资本开支及损耗)
  • 可在 330 kV 并网,容量达 200+ MW
  • 双 330 kV 进线提供强故障水平支撑(Sydney South / Sydney West)
  • 电压闪变和谐波风险低于弱区域节点

Supports Sydney Reliability & Growth支撑 Sydney 可靠性与增长

  • Serves a fast-growing load centre
  • Anchored by Western Sydney Airport, data centres, commercial users, and growing residential demand
  • BESS provides contingency response during outages on Sydney-West corridors
  • Helps defer/reduce costly transmission upgrades in South-West Sydney
  • 服务于快速增长的负荷中心
  • 以 Western Sydney Airport、数据中心、商业用户及住宅需求为支撑
  • BESS 可在 Sydney-West 走廊故障时提供应急响应
  • 有助于延缓/减少 South-West Sydney 显贵的输电升级

Revenue Optimisation in the NEMNEM 收益优化

  • Located in Sydney load zone — stronger arbitrage margins
  • High MLF (>1) due to proximity to load — avoids long-distance transmission losses
  • Access to all 8 FCAS markets (regulation + contingency; raise/lower)
  • 位于 Sydney 负荷区——更强套利空间
  • 高 MLF (>1),贴近负荷,避免远距离输电损耗
  • 可参与全部 8 个 FCAS 市场(调频 + 应急;升/降)

System Strength & Technical Services系统强度与技术服务

  • Enhances system strength in South-West Sydney (important for incoming data centre loads)
  • Contributes to AEMO performance standards
  • Potential to contract with Transgrid/AEMO for non-market ancillary services (network support / system security)
  • 增强 South-West Sydney 系统强度(对新增数据中心负荷至关重要)
  • 符合 AEMO 性能标准

  • 可与 Transgrid/AEMO 签约提供非市场辅助服务(网络支持 / 系统安全)

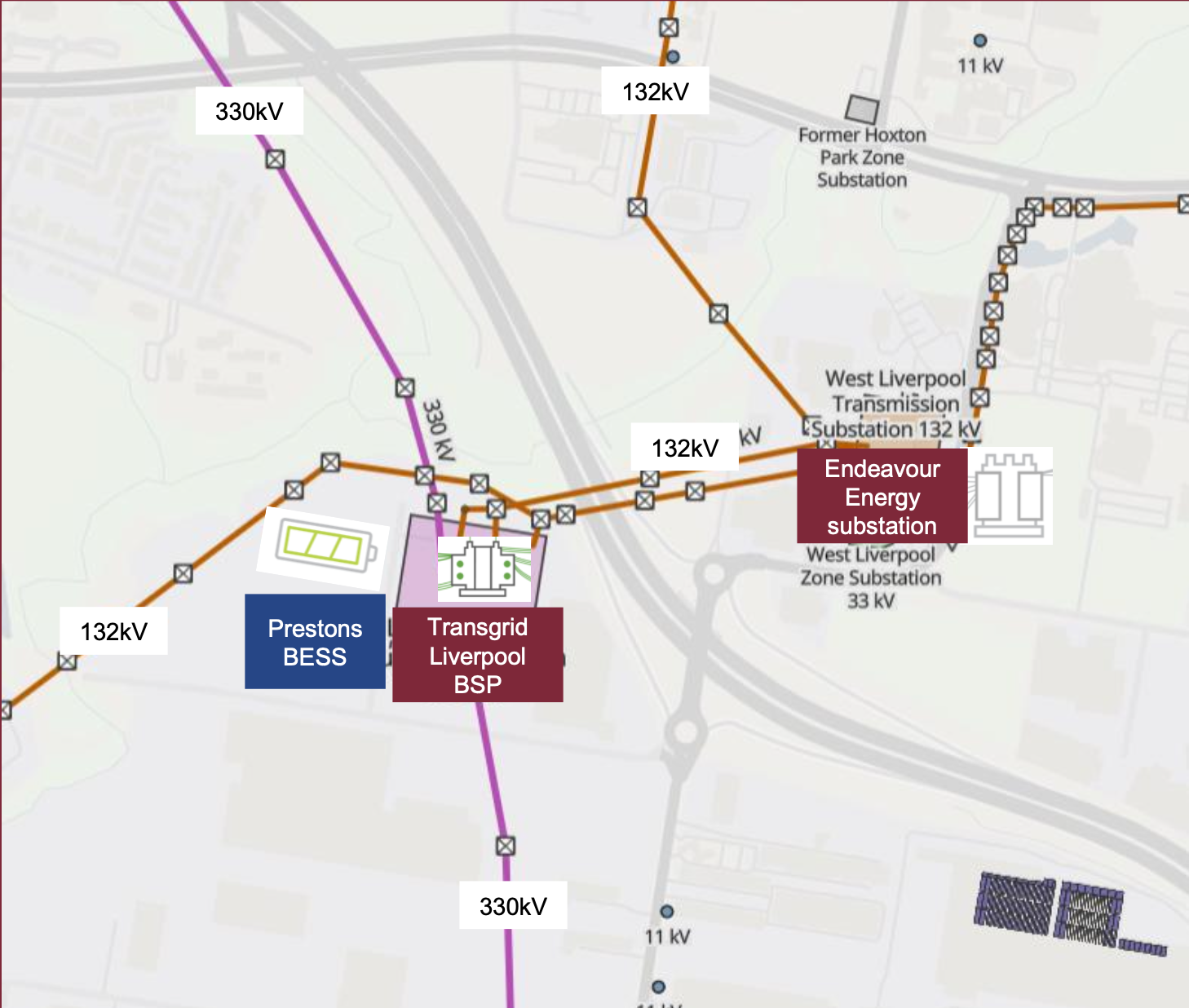

BESS Site Annotated Map
Prestons BESS | Adjacent to Transgrid Liverpool BSP

Development Program & Decision Gates开发计划与决策节点

Draft Term Sheet草拟 Term Sheet
29 Feb 2026
Rudder Go / No-Go GateRudder 决策节点
June 2026
NTP / FID TargetNTP / FID 目标
1 May 2028
Workstream Q1 '26Q2 '26Q3 '26Q4 '26 Q1 '27Q2 '27Q3 '27Q4 '27 Q1 '28Q2 '28 Q3 '28Q4 '28 Q1 '29Q2 '29Q3 '29Q4 '29
Agreement in principle (HOA)
Partner & ESR project approval
Execute HOA / Term Sheet
Finalise landowner legals
Preliminary enquiry
ESR pre-DD
⬥ Rudder Go / No-Go Gate
Detailed due diligence
ESR & partner final approval
Upfront costs
Development application (DA)
Grid connection application
★ NTP / FID
Exercise lease
OEM procurement
Construction & commissioning
★ COD

Key devex    Supporting    Ancillary    Post-FID    Milestone    Decision Gate

Key Term Sheet PointsTerm Sheet 核心条款

Parties & Structure合作方与架构

  • Investment vehicle (JV / Venture SPV) between ESR and Rudder
  • Rudder holds 90–95% of shares and contributes 90–95% of capital (majority control)
  • 由 ESR 与 Rudder 设立投资载体(JV / Venture SPV)
  • Rudder 持有 90–95% 股份并出资 90–95%(多数控制权)

Capital Contributions资本出资

  • Staged contribution schedule
  • Each stage budget reviewed in IRC and confirmed by Rudder
  • Overspend protection: if actual spending is >10% over the agreed estimate, ESR covers the excess
  • 分阶段出资计划
  • 每阶段预算经 IRC 审查并由 Rudder 确认
  • 超支保护:实际支出超过商定估算 >10% 时,由 ESR 承担超出部分

Fees费用

  • ESR Development Fee: 4% (applies to pure devex; excludes land-related holding costs)
  • Project Acquisition Fee: capped at AUD 500k (negotiated down from AUD 1m), payable upon FID realisation
  • ESR Development Fee:4%(仅适用于纯 devex,不含土地持有成本)
  • Project Acquisition Fee:上限 AUD 500k(已从 AUD 1m 谈下),FID 实现时支付

Exit / Reinvest Rights退出 / 再投资权利

  • Rudder can exit at FID (end of Phase 1)
  • Exit price set by independent third-party valuer appointed/elected by Rudder
  • Alternatively Rudder may roll shares into Phase 2 (build-own-operate to COD)
  • If rolling, conversion is based on the FID sale price
  • Rudder 可在 FID 时退出(Phase 1 结束)
  • 退出价格由 Rudder 指定的独立第三方估值师确定
  • 也可将股份转入 Phase 2(建设-运营至 COD)
  • 转入时按 FID 销售价格折算

Governance & Protections治理与保护

  • Reserved matters aligned with Rudder’s majority capital contribution
  • Clear gate in June 2026 after pre-DD review: proceed to long-form or walk away
  • 保留事项与 Rudder 的多数出资地位匹配
  • June 2026 明确决策节点:完成 pre-DD 审查后,决定继续或退出

Forecast & Exit Pathway预测与退出路径

Target Cost at FIDFID 目标成本
≤ AUD 12 m
Phase 1 DurationPhase 1 周期
~24 months
FID TargetFID 目标
May 2028
Connection接入方式
BSP Bay
Equity IRR
30% – 120%
MOIC
1.2x – 2.0x
EV Multiple
AUD 140k – 190k / MW
MLF (Marginal Loss Factor): MLF affects how much revenue is realised at settlement after transmission losses. MLF > 1 is beneficial; it can improve delivered revenue and bankability compared with remote nodes. Prestons is in the Sydney load zone near Liverpool BSP; proximity to load supports stronger MLF outcomes. MLF 影响结算时扣除输电损耗后的实际收入。 MLF > 1 有利,可提升实际收入及可融资性。 Prestons 位于 Sydney 负荷区近 Liverpool BSP,贴近负荷支撑更优 MLF 表现。

Exit Pathway at FIDFID 退出路径

Exit Timing退出时机

At Final Investment Decision (FID), ESR facilitates entry of long-term, lower-cost infrastructure capital (super funds, infra funds).

Devex investors realise value uplift at FID exit.

在 FID 时,ESR 促成长期低成本基础设施资本进入(养老基金、基建基金等)。

Devex 投资者在 FID 退出时实现价值提升。

Capital Transaction资本交易

ESR manages transaction execution and handover to incoming investors.

Devex investors can:

  • Exit fully at FID and realise returns, or
  • Reinvest alongside ESR and new capital in the build-own-operate phase

ESR 负责交易执行及向新投资人移交。

Devex 投资者可:

  • 完全退出并在 FID 实现回报,或
  • 再投资与 ESR 及新资本共同进入建设-运营阶段

ESR’s RoleESR 的角色

Acts as developer and transaction sponsor, leveraging:

  • Market relationships with capital
  • Proven track record on capital raising and project delivery

Ensures seamless transition and alignment between Devex investors and long-term ownership.

作为开发商及交易发起人,借助:

  • 与资本方的市场关系
  • 在资本募集及项目交付方面的过往业绩

确保 Devex 投资者与长期持有者之间平稳过渡。
